Most Power Sought for US Data Centers Will Never Materialize

image is BloombergMedia_TIMQDWT96OSG00_12-08-2026_11-00-04_639220896000000000.png

BloombergNEF, DC Byte

More than two-thirds of the electricity sought for the artificial intelligence boom in the US isn’t likely to materialize due to “phantom” projects and long-shot pitches.

That’s based on new projections from Wood Mackenzie, which sees US grid operators and utilities likely committing to about 28% of the 1,066 gigawatts requested for data center projects. A gigawatt is the equivalent generating capacity of a traditional nuclear reactor.

While no one expects every proposed project to be built, the data reveals how inflated projections of future power demand complicate planning and budgeting by utilities and grid operators. That can translate into higher utility bills, since capital costs for upgrading infrastructure are typically covered through rate hikes.

“Everyone’s trying to figure out the rules of the road in order to make this the most efficient process without increasing grid prices,” said Alex Klaessig, co-founder of energy market intelligence firm Halcyon.

Developers have been taking a shotgun approach to pitching projects to utilities, seeking to get ahead in the AI build-out. That’s overwhelming US grids and creating even more data center bottlenecks. The explosion of requests is stretching approval timelines, forcing more applications to be vetted than ever before, and threatening to undermine US efforts to compete in the global AI race.

“If we don’t allow these data centers to come online as fast as we can, then we might lose the future benefits of AI,” Klaessig said.

Some developers are pitching the same project to multiple utilities, with plans to push ahead with the application that lands the best deal and speediest approval. That creates what the industry calls “phantom” applications, complicating efforts to accurately forecast true power demand.

“Grid operators don’t know which ones are real and which ones aren’t,” said Glenn Schwartz, who heads energy policy at consulting firm Rapidan Energy Group. He estimates that only 20% to 30% of the power that developers are seeking will go toward projects that get built, due in part to phantom requests.

Flooded grid queues aren’t specific to data centers: renewables projects are regularly hampered by long wait times to connect to electrical networks across the world.

While it’s impossible to determine how many requests are duplicates, Reid Ramdathsingh of Rystad Energy estimates about half of the applications are credible on the biggest US grid, operated by PJM Interconnection LLC, which serves 67 million Americans from Illinois to Virginia. He sees 14% of applications as legitimate on the main grid in Texas, a state that has seen the fastest data center growth.

PJM said in a statement that it has taken steps to improve the forecasting of large loads.

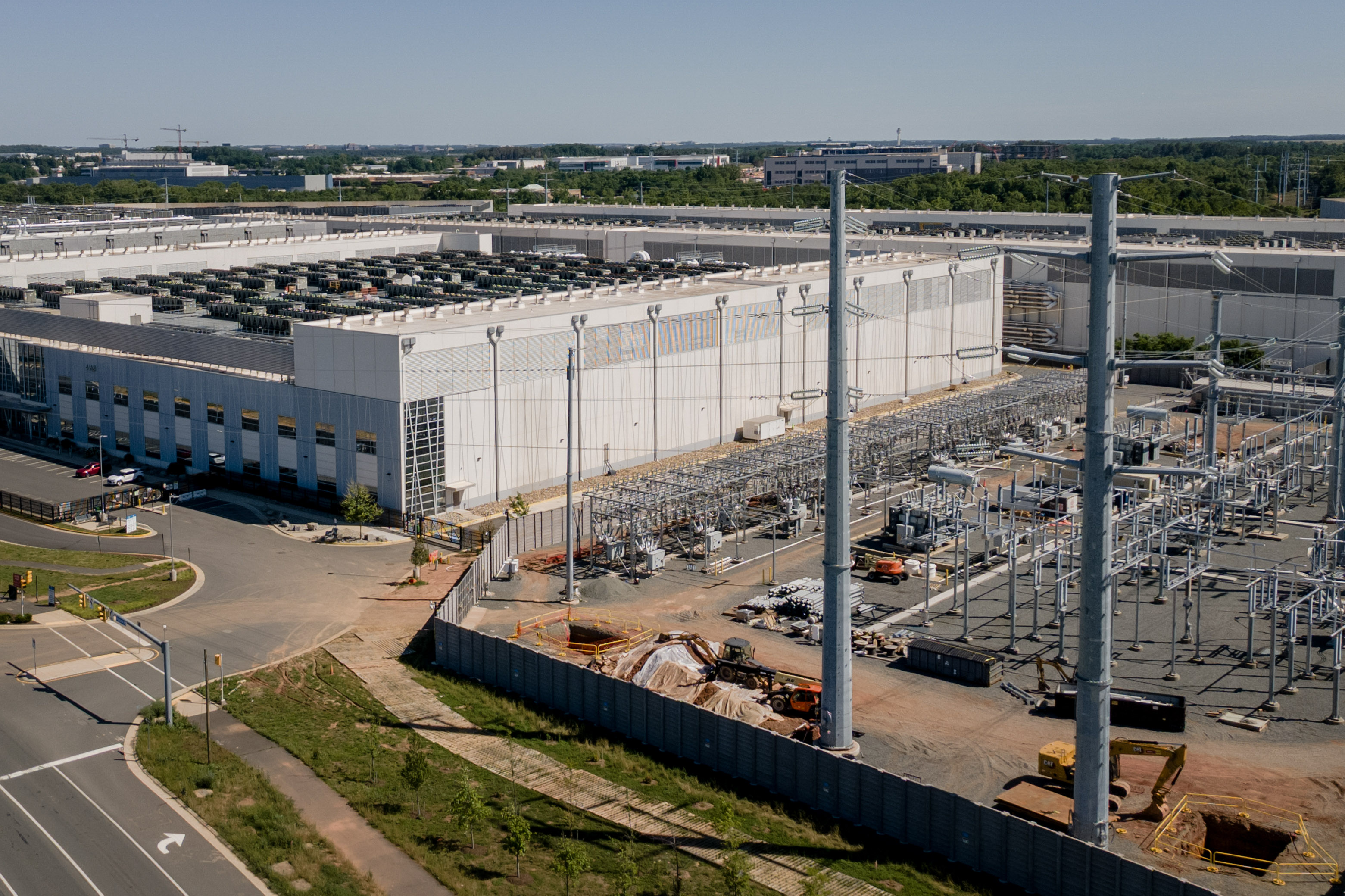

Photographer: Lexi Critchett/Bloomberg

Of course, the 1,066 gigawatts of applications cited by Wood Mackenzie would require a staggering jump in US electric capacity. The amount represents 83% of the nation’s total utility-scale generation capacity at the end of last year, according to the US Energy Information Administration.

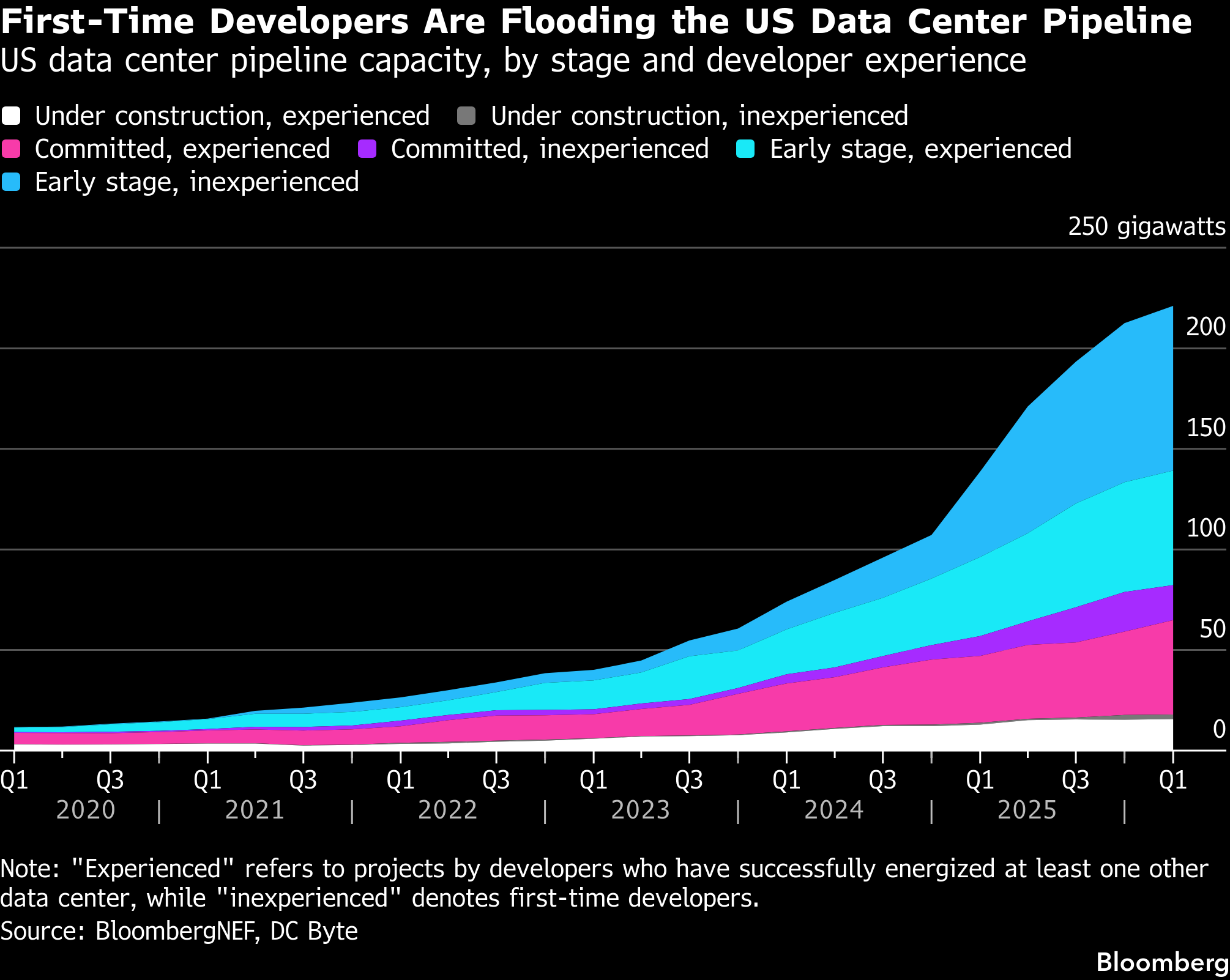

Many applications are from firms with no prior experience building facilities with energy needs that can rival mid-sized cities. The projects of those first-time developers are often disproportionately large, though generally less likely to come to fruition than those from well-established big technology firms, said Wood Mackenzie analyst Caitlin Connelly.

To crack down on the barrage of requests, many utilities have introduced steep upfront application costs, demanding big-money collateral and near-perfect credit ratings. Such requirements are squeezing small to mid-sized developers that often pay project costs up front and then sell completed facilities to well-capitalized AI companies.

Getting through a queue used to be straightforward with utilities offering up electricity to developers, according to Brad Richter, senior vice president of energy at Hut 8 Corp., which manages 11 data centers. Now, for the most part, utilities are saying, ‘I don’t have it anymore,’” Richter said, noting that those power providers are increasingly “closed for business.”

Photographer: Kaylee Greenlee/Bloomberg

In Texas, Governor Greg Abbott ordered regulators on Aug. 3 to audit every data center seeking access to the state’s main grid, effectively pausing those projects’ approvals until reviews are complete. His surprise call puts $13 billion in industry revenues at risk and threatens to delay almost a fifth of America’s data center pipeline in the medium term, according to BloombergNEF.

The Electric Reliability Council of Texas is tracking about 474 gigawatts of connection requests, with around 90% of those from data centers, according to Abbott. That total is more than five times the system’s record peak demand.

Ercot uses multiple screening stages to distinguish between speculative and credible projects, a spokesperson said.

Exelon Corp., a utility owner serving customers from Illinois to Delaware, in July slashed its pipeline of energy demands from data centers by nearly 40%, leaving a queue of about 11 gigawatts. Exelon is prioritizing connection requests that are likely to come to fruition.

“Utilities are using what they’ll refer to as a ‘first-ready, first-served’ model, as opposed to a ‘first-come, first-served’ model, to weed out folks that really don’t have the capability to deliver,” said Brian Janous of Cloverleaf Infrastructure LLC, which works with utilities to develop ready-to-build sites for data center users and providers.

©2026 Bloomberg L.P.

By Gabriel Levin , Emily Forgash
